Overview

Every project can specific the types of tasks that are relevant to the project. Similarly, the tasks project may also come up with a categorization of priority to determine the order in which tasks must be carried out. Deeper dive of these tasks by the priority assigned to them will ensure that the time spent on such analysis helps with the value realization of the MVP (minimum viable product). Whether a project is plan-driven, adaptive, or hybrid, looking into these priority level analysis can build the project team to self-organize and be proactive in avoid project delays.

Task Priority Setup in Spira

In Spira, the Task Priority is set up as part of the template used for the product. Shown below is where the task priority can be accessed and set up.

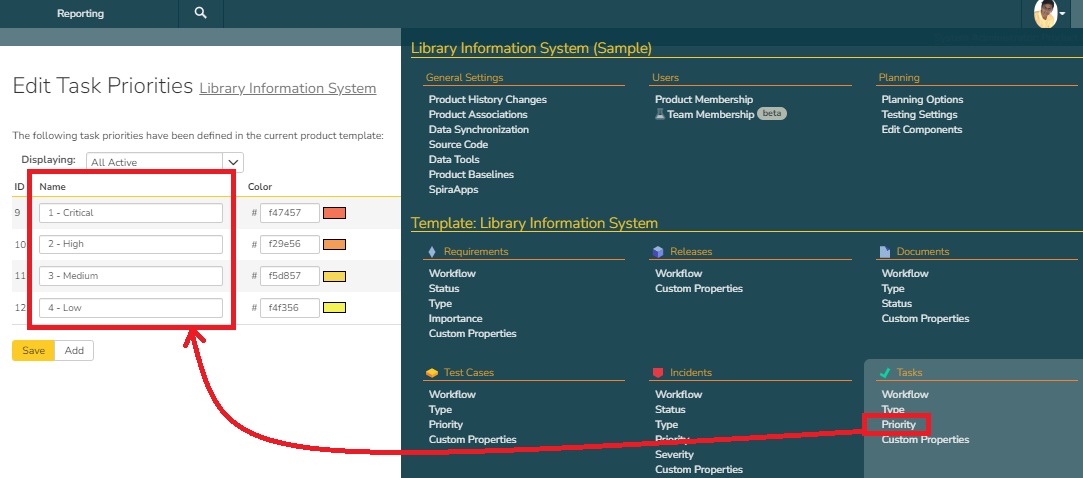

Task Priority Setup



Query

Given below is the Query

select
   T.TASK_PRIORITY_NAME,
   SUM(T.NOT_STARTED) as NS_COUNT,
   SUM(T.IN_PROGRESS) as WIP_COUNT
from
 (
  (select
    Case when R.TASK_PRIORITY_NAME is null then "Unknown Type" else R.TASK_PRIORITY_NAME end as TASK_PRIORITY_NAME,
    COUNT(R.TASK_ID) as Not_Started,
    0 as In_Progress
   from
    SpiraTestEntities.R_Tasks as R
   where
    R.PROJECT_ID = ${ProjectId} and
    R.IS_DELETED = False and
    R.TASK_STATUS_NAME ="Not Started"
   group by
     R.TASK_TYPE_NAME)
   union
   (select
     Case when R.TASK_PRIORITY_NAME is null then "Unknown Type" else R.TASK_PRIORITY_NAME end as TASK_PRIORITY_NAME,
     0 as Not_Started,
     COUNT(R.TASK_ID) as In_Progress
    from
     SpiraTestEntities.R_Tasks as R
    where
     R.PROJECT_ID = ${ProjectId} and
     R.IS_DELETED = False and
     R.TASK_STATUS_NAME ="In Progress"
    group by R.TASK_PRIORITY_NAME)
 ) as T
group by
  T.TASK_PRIORITY_NAME

Query Explanation

  1. This query combines inner queries.
  2. The first inner query focuses on counting the tasks associated by the task priority for tasks in the not started state. It assigns 0 to the in progress state.
  3. The second inner query focuses on counting the tasks associated by the task priority for tasks in the in progress state. It assigns 0 to the not started state.
  4. The outer query summarizes the results of the two inner queries.
  5. The where clause in each inner query
    1. filters for specific status (e.g.: TASK_STATUS_NAME = "In Progress")
    2. picks tasks that are not deleted (IS_DELETED = False)
    3. applies the current project selection (PROJECT_ID = ${ProjectId})
  6. NOTE: This query still needs to use the TASK_STATUS_NAME in the subquery where clauses.

Output

Given below is the resulting data.

Task Priority Data Grid



Graph

Given below is the graph.

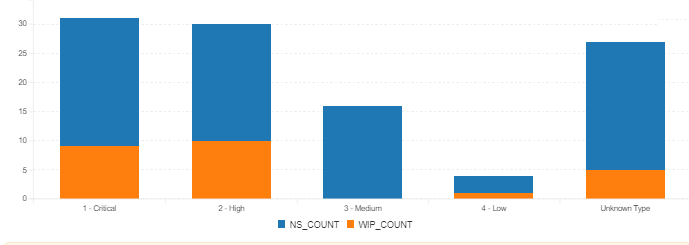

Task Priority Bar Graph



Graph Interpretation

  1. The lean principle of flow preservation in any project requires why tasks remain in the WIP state. For the various task priorities mentioned, this may provide insights related to the direction and self-organization required for how priority is assigned. While the graphs themselves will not give the reasons, it prompts one to use these KPIs to dig deeper.
  2. The next focus is also understanding why some tasks are waiting to be started. Analyzing the root causes may lead one to get detailed in the documentation (e.g.: Agreeing on a formal definition of done, incorporating the INVEST principle, business objective clarity, etc.).
